You Have 18 Months to Get Commercial Solar Installed and Operational

commercial solar December 2027 deadline

The safe harbor window closed on July 4, 2026. If your business didn’t lock in the federal solar tax credit by then, there’s exactly one path left.

Let’s skip the recap of what happened with the One Big Beautiful Bill Act. If you’re reading this, you probably already know the basics: the federal government rewrote the rules on clean energy tax credits, and commercial solar got a hard deadline.

Here’s where things stand right now:

Your business can still claim a 30% federal Investment Tax Credit (ITC) on a commercial solar installation — but only if the system is fully placed in service by December 31, 2027.

“Placed in service” doesn’t mean panels are on the roof. It doesn’t mean the installer finished the job. It means your utility has issued Permission to Operate (PTO) — the official sign-off that your system is live, connected to the grid, and generating power. That’s the IRS standard. Anything short of that, and you don’t qualify.

Eighteen months sounds comfortable. It’s not. Here’s why.

What 18 Months Actually Looks Like

Commercial solar projects aren’t like residential installs. You don’t sign a contract on Monday and flip a switch three weeks later. A commercial system moves through six distinct phases, each with its own timeline, dependencies, and potential delays.

Here’s a realistic breakdown for a mid-size commercial project in Florida (100–500 kW):

PhaseWhat HappensTypical Duration
1. Consultation & FeasibilitySite visit, energy analysis, load data review, financial modeling, initial proposal2–4 weeks
2. Design & EngineeringDetailed electrical drawings, structural calculations, equipment specifications, interconnection study4–8 weeks
3. PermittingBuilding permits, electrical permits, zoning approvals, AHJ review6–12 weeks
4. Utility Interconnection ApplicationApplication filed, queue position assigned, utility engineering review, transformer/service upgrade assessment8–24 weeks
5. Procurement & SchedulingEquipment ordering, delivery coordination, crew scheduling4–8 weeks
6. InstallationRacking, panels, inverters, wiring, electrical connections3–8 weeks
7. Inspection & CommissioningFinal building inspection, utility inspection, system testing, meter programming2–4 weeks
8. Permission to Operate (PTO)Utility final review and formal PTO issuance2–6 weeks

Best-case total: 7–8 months (everything goes perfectly, small system, cooperative utility)

Realistic total: 10–14 months (mid-size system, normal permitting, standard utility queue)

Worst-case total: 16–20+ months (large system, transformer upgrade needed, permitting delays, hurricane season interruption)

The math: If you start the process today (July 2026), a realistic 12-month project puts you at PTO in July 2027 — with 5 months of buffer. Wait until January 2027, and a 12-month timeline puts you at January 2028. That’s too late. The credit is gone.

The Phases That Catch People Off Guard

Utility interconnection is the wild card

This is where most commercial projects lose time they can’t get back. Your installer can move fast. Your permits can sail through. But the utility operates on its own schedule.

In Florida, interconnection timelines vary dramatically depending on your utility and system size:

  • GRU (Gainesville): GF&L (Gainesville Regional Utilities): Generally responsive, but commercial reviews still take 4–8 weeks after application.
  • Duke Energy: Typically 6–12 weeks for review. Larger systems requiring transformer upgrades can push to 16+ weeks.
  • FPL: Interconnection queue backlogs have been reported across the state. 8–16 weeks is common for commercial.

If your project requires a transformer upgrade or service panel modification — which many commercial installations over 200 kW do — add another 8–16 weeks for the utility to schedule and complete that work. You can’t control this timeline. You can only get in line earlier.

commercial solar tax credit after safe harbor

Permitting is slower than you expect

Florida doesn’t have a single statewide permitting process for commercial solar. Each county and municipality has its own requirements, review timelines, and inspection schedules. Some jurisdictions turn around commercial permits in 3–4 weeks. Others take 8–12 weeks for the initial review alone.

Plan for 60–90 days minimum on permitting for any Florida commercial project. If your property is in a historic district, flood zone, or has HOA/deed restrictions, add more time.

Hurricane season is half your timeline

Florida’s hurricane season runs June through November — which covers roughly half of your remaining 18-month window. A single major storm can shut down construction for weeks, delay equipment deliveries, pull crews to emergency work, and push utility inspections back indefinitely.

This isn’t a scare tactic. It’s a scheduling reality. Projects that break ground before hurricane season have a fundamentally different risk profile than projects that start during it.

What the 30% Credit Is Actually Worth — and What You Lose Without It

The ITC isn’t an abstract benefit. It’s a direct reduction of your federal tax bill. Here’s what it looks like on a real project:

With 30% ITC
(installed by Dec 2027)
Without ITC
(miss the deadline)
System size200 kW200 kW
Installed cost$400,000$400,000
30% ITC–$120,000$0
MACRS depreciation (Year 1 bonus)–$109,200*–$156,000*
Effective net cost~$170,800~$244,000
Estimated annual savings~$38,000~$38,000
Simple payback~4.5 years~6.4 years

*MACRS depreciation value changes because the depreciable basis is reduced by 50% of the ITC when the credit is claimed. Both scenarios assume 100% bonus depreciation and a 21% corporate tax rate. Your actual numbers will vary — talk to your CPA.

That $120,000 ITC is real money. It’s the difference between a project that pays for itself before your next lease renewal and one that takes significantly longer. For larger systems — 500 kW, 1 MW — the numbers scale proportionally. A 500 kW system loses roughly $300,000 in tax credit value. A 1 MW system: $600,000+.

That money doesn’t shift to some other incentive. It disappears. After December 31, 2027, there is no federal Investment Tax Credit for commercial solar projects that didn’t start construction before July 4, 2026. Period.

Working Backwards from December 31, 2027

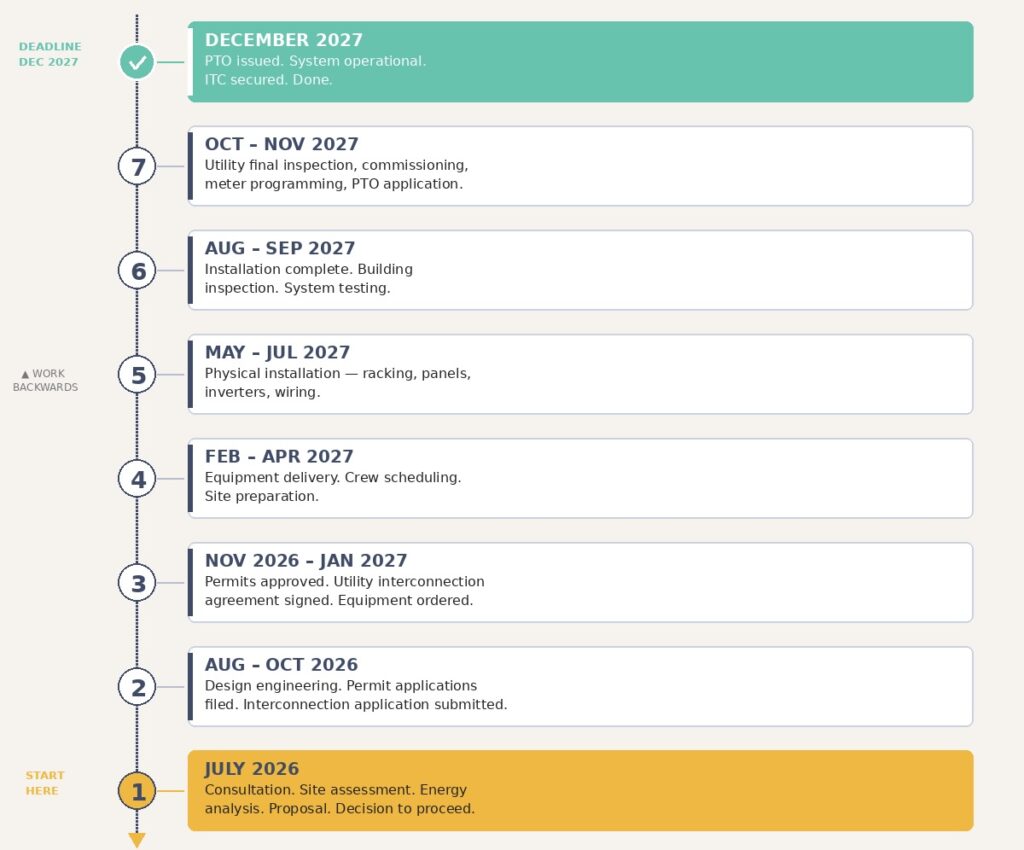

Here’s what a realistic project timeline looks like when you start from the deadline and work backwards:

how long commercial solar installation

Notice what this timeline assumes: everything goes right. No permitting delays. No utility queue backlog. No supply chain disruption. No hurricane shutdown. Every month you wait past July 2026 compresses the schedule further and eliminates your margin for error.

Why Moving First Matters More Than Usual

Here’s something most articles about this deadline won’t tell you: the businesses that move first don’t just beat the deadline — they get better projects.

  • Installer capacity: Installer availability narrows as the deadline approaches. Every commercial solar installer in Florida is looking at the same December 2027 deadline. The ones who book projects now get first priority on crew scheduling.
  • Equipment costs: Equipment pricing is more favorable now than it will be. Demand spikes drive prices up. As the deadline approaches and order volumes surge, expect lead times to extend and pricing to increase — especially for inverters and transformers.
  • Utility queue position: Earlier applications mean shorter wait times. Interconnection queues are first-come, first-served. Filing your application in Q3 2026 puts you ahead of the wave. Filing in Q1 2027 puts you behind it.
  • Schedule margin: Earlier projects have room to absorb setbacks. A project that starts in August 2026 has 16 months of runway. A project that starts in March 2027 has 9 months. One can survive a hurricane delay. The other can’t.

What to Do Right Now

If your business is considering commercial solar and you want the 30% federal tax credit, here’s the honest assessment:

Start the conversation this month. Not this quarter. Not after the holidays. This month. A consultation and site assessment takes 2–4 weeks.

Talk to your CPA early. The ITC, MACRS depreciation, and potential bonus adders (domestic content, energy community) all affect your tax planning. Your CPA needs time to model this before year-end.

Get a realistic timeline for your specific project. A 50 kW rooftop system has a very different timeline than a 500 kW ground-mount. The only way to know if your project can make the December 2027 deadline is to start the assessment.

Don’t assume you have until 2027 to decide. You have until 2027 to finish. The decision needs to happen now — because 12–14 months of project work has to follow it.

The Bottom Line

December 31, 2027 is not a planning deadline. It’s a completion deadline. Your system has to be installed, inspected, connected, tested, and formally approved by your utility before that date — or the 30% federal tax credit no longer exists for your project.

Eighteen months sounds like plenty of time until you map out what actually has to happen in those months. The businesses that act now will get the credit, the better pricing, and the stronger ROI. The ones that wait will either rush through a compromised project or miss the window entirely.

PPM Solar designs and installs commercial solar systems across Florida. If you want to know whether your project can make the December 2027 deadline, schedule a commercial consultation — the assessment is free, and it’s the fastest way to get a realistic answer.
